Introduction
Client: Crawfords
Location: 90 St Vincent Street, Glasgow, G2 5UB
Project Reference: 234058
Surveyor: Ross Cooper
Project Manager: Alan Harkins
Contractor: Stellar Insurance Reinstatement Services
Duration: 18 Days
Project Overview
The refurbishment of the 3rd and 4th floors at 90 St Vincent Street was undertaken to modernize and restore the office space following insurance-related damage.
The project included comprehensive upgrades to Electrical systems, Plumbing, Joinery, Tiling, Decoration, and Flooring, with a main focus on minimizing disruption to the operations of the client’s business.
Scope of Works
3rd Floor
Spaces Refurbished: Main entrance, kitchen, LH & RH office sides, storage room, meeting room.
Key Activities:
- Electrical Inspection along with Power & Lighting Upgrade.
- Plumbing upgrades including sink and appliance replacement.
- Joinery works: removal and installation of units, worktops, and wall tiles.
- Tiling and grouting.
- Full decoration including emulsion, woodwork, and doors.
- Flooring replacement.
4th Floor
Spaces Refurbished: Front meeting room, kitchen, LH & RH office sides.
Key Activities:
- Similar scope as 3rd floor with increased unit and tile quantities.
- Additional joinery and decoration tasks.
Programme Timeline
| Milestone | Activity | Dates | Notes |
|---|---|---|---|
| Project Start | Initial setup | 10–12 Oct | Weekend start |
| Milestone 1 | Electrical EICR & upgrade | 12–14 Oct | 4 men, 14-hour shifts |
| Milestone 2 | Decoration | 12–27 Oct | Out-of-hours |
| Milestone 3 | Kitchen renewals | 19–20 Oct | Weekend work |
| Milestone 4 | Carpet tiles (3rd floor) | 19–20 Oct | Weekend work |
| Milestone 5 | Carpet tiles (4th floor) | 26–27 Oct | Weekend work |
| Milestone 6 | Final clean & sign-off | 28 Oct | Completion |
Visual Transformation
The photographic documentation highlights the dramatic improvements:

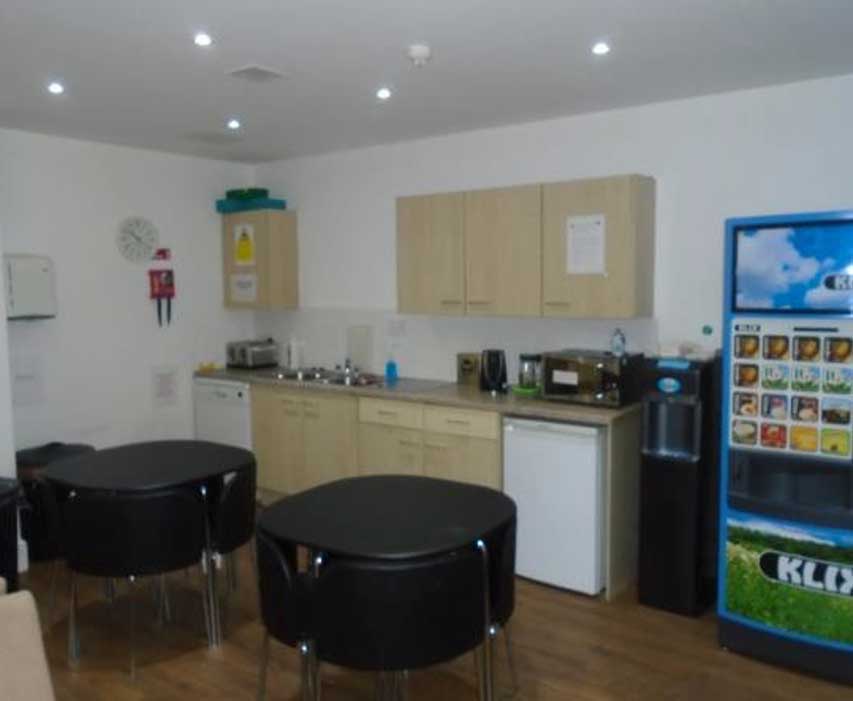

Kitchen Areas: Upgraded with new units, worktops, appliances, and tiling. Before-and-after images show a shift from dated finishes to modern, clean aesthetics.

Office Spaces: Enhanced with LED lighting, dove grey walls, glossed woodwork, and new carpet tiles.

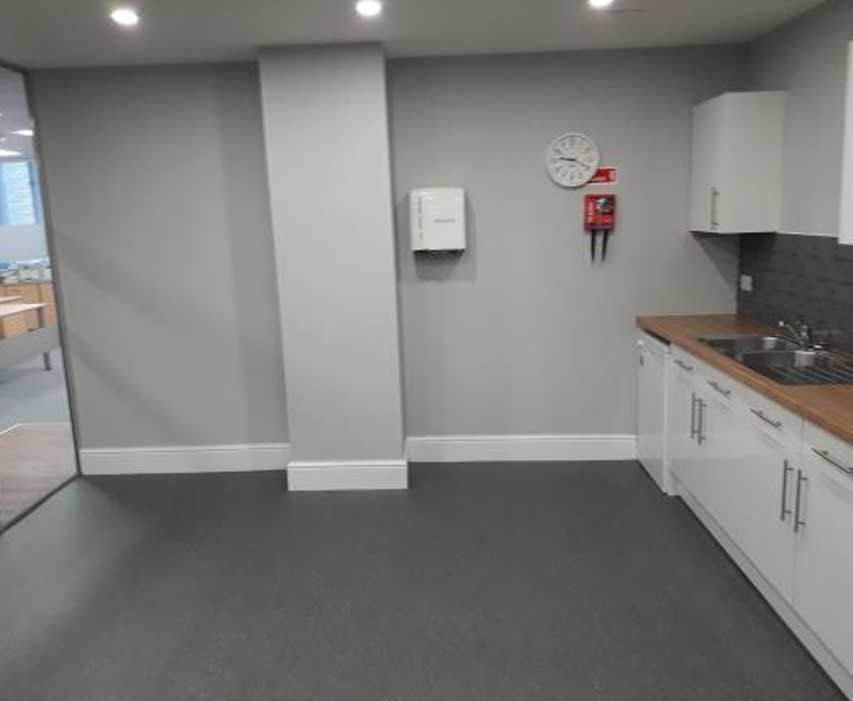

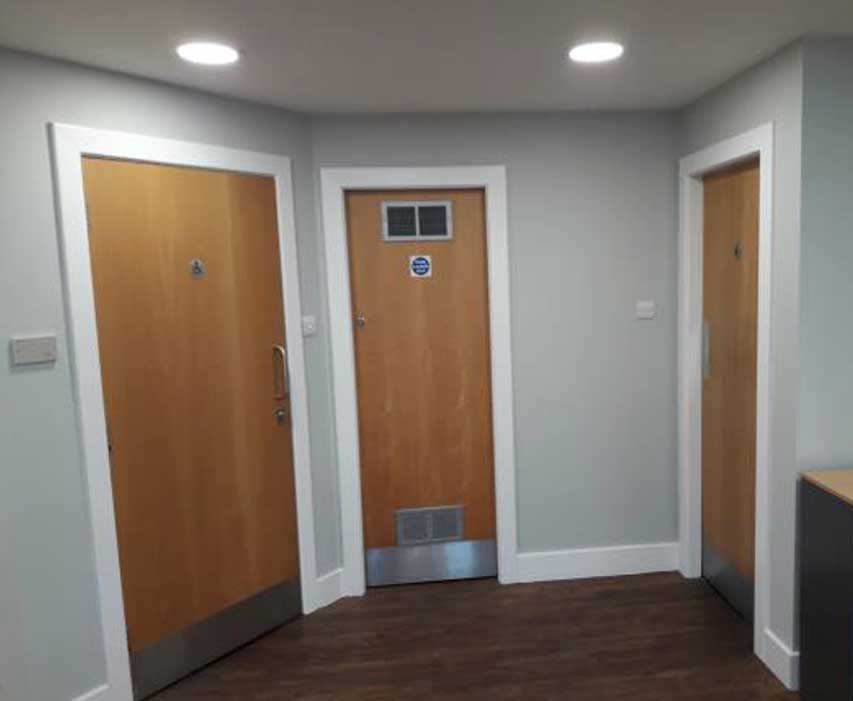

Toilets & Storage: Refreshed with updated fixtures and finishes.
Outcomes and Impact
Minimal Disruption: Strategic scheduling over weekends and evenings ensured clients business continuity.
Quality Finish: High-standard materials and workmanship across all trades.
Client Satisfaction: Delivered on time and within scope, meeting all refurbishment goals.
